Definition

In logistics, the Kanban method is a signal that authorizes replenishing material only when it is consumed, not when a calendar pushes stock. That signal is usually a card, an empty container, or a system alert; the column board is the most common visual way to track it.

If your kanban triggers freight expedites every week, you do not have demand-driven replenishment: you have a fire with cards.

Related: inventory · safety stock · just-in-time · WMS · warehouse functions.

What the Kanban method is (definition and origin)

Kanban (看板) means “card” or “visual sign” in Japanese. It emerged at Toyota in the 1950s, driven by Taiichi Ohno as part of the Toyota Production System: replenish like a supermarket, only what the next process already withdrew.

In warehouse and supply chain work, kanban is not “another task board.” It is a demand-driven (pull) replenishment method: consumption fires the authorization to move or make. The board (Backlog, Doing, Done) is the view; the signal is the engine.

It is often mixed up with just-in-time (JIT). JIT is the flow goal (less idle inventory). Kanban is a concrete mechanism to get closer to that goal without pushing stock blindly.

How it works: cards and boards

The cycle is simple: material is consumed, the signal is released, someone acts, and stock returns to the agreed level. If the signal travels without real action (only “updating the chat”), the method breaks.

A well-built kanban card answers five questions: which product, how much, in how much time (lead time), who supplies it, and which location receives it. Without those fields, the signal is noise.

The visual board limits work-in-process inventory: only so many signals can sit in “Doing.” That kills fire-drill counting when everyone orders at once.

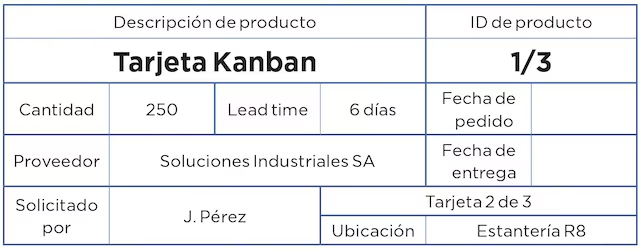

Spanish Kanban card example with product, quantity, lead time, supplier, and location
Kanban card example: product, quantity, lead time, supplier, requester, and location. The signal only works when those fields are complete.

Visual board

Replenishment kanban

Backlog2

  • Empty container SKU-A120

    Replenishment signal · aisle 4

  • Stretch film order

    2 pallets · ABC

Doing2

  • Move to dock

    Internal replenishment

  • Laredo pickup

    Appointment confirmed

Review2

  • Validate lead time

    Vs safety buffer

  • Inbound proof of delivery

    Evidence pending

Done3

  • Stock put away

    WMS updated

  • Cycle closed

    Shift B

  • Appointment met

    No freight expedite

Example replenishment signals across warehouse and freight. Seeing work in progress kills fire-drill counting.

Kanban types: transport (T) and production (P)

Two classic signals show up in industrial and logistics practice. Transport kanban (T) authorizes moving material from one point to another (supplier to warehouse, warehouse to line, DC to customer). Production kanban (P) authorizes making or transforming when the next process has already consumed.

In a multi-warehouse network, demand “pulls” right to left with T and P signals; material advances left to right when the signal is fulfilled. If you mix T and P without a clear owner, you overbuy or stop the line.

You will also see purchase variants (external supplier), transfers between DCs, and lot signals (replenish only after N empties). The principle does not change: consumption first, authorization second.

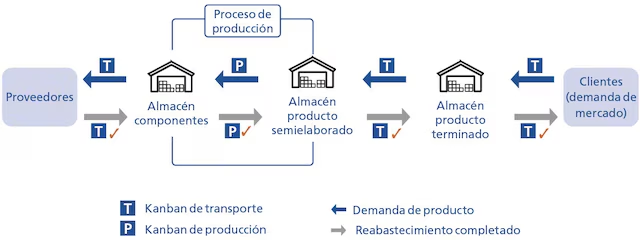

Diagram of transport (T) and production (P) kanban from suppliers to customers
How transport (T) and production (P) kanban work: demand pulls toward suppliers; completed replenishment flows toward the customer.

Transport (T)

What it authorizes: Move a quantity between locations

Where it shows up: Supplier ↔ warehouse, aisle ↔ dock, DC ↔ customer

Production (P)

What it authorizes: Make or transform a lot

Where it shows up: Line, assembly, packing, kitting

Purchase / supplier

What it authorizes: Order from an external party

Where it shows up: Inbound replenishment with freight lead time

Transfer

What it authorizes: Move between nodes in the same network

Where it shows up: Central DC ↔ satellite or cross-dock

Classify the signal by the action it authorizes, not by card color.

Physical kanban vs e-Kanban

Physical kanban uses cards, empty containers, or floor boards. It is visible, cheap to start, and fragile if cards get lost or consumption is not recorded.

e-Kanban (electronic kanban) digitizes the same signal: scanning a barcode or QR code generates the replenishment alert to purchasing, production, or transport. The label is still “the card”; the scan is the messenger.

The warehouse management system (WMS) is not “kanban”: it executes locations, picks, and confirmations. Kanban defines when and how much to replenish. Together they shrink the human bridge between the floor and the order.

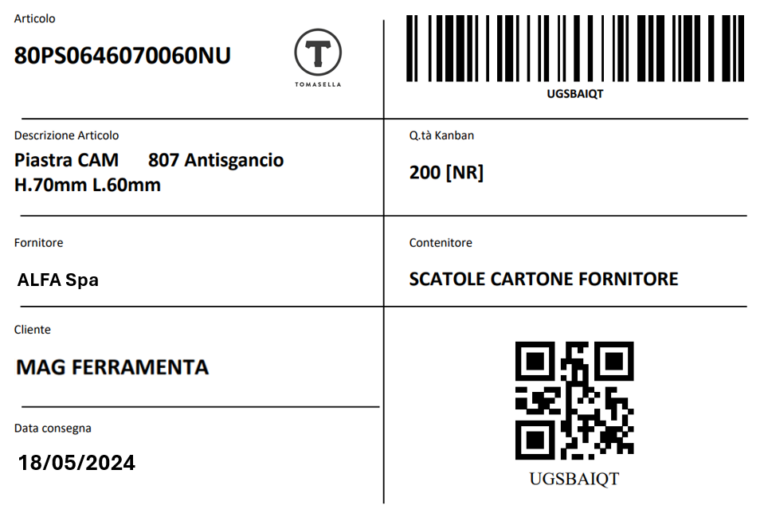

Real e-Kanban label with barcode and QR code to fire the digital replenishment signal
Real e-Kanban label example: barcode and QR turn the card into a digital signal when scanned (quantity, supplier, container, and destination travel with the SKU).
CriterionPhysicale-Kanban
SignalCard / empty containerScan event or system threshold
VisibilityLocal (board / aisle)Network (DC, purchasing, supplier)
Typical riskLost or late cardMissed scan or bad master data
Fits whenFew SKUs, one nodeMany SKUs, multi-node or suppliers
Choose the signal channel; do not change the pull logic.

Advantages and limits

Kanban shines when consumption is relatively stable, lead time is measurable, and people do not “advance” signals. It fails when freight lead time is a wish and safety stock is invented by dogma.

AdvantageLimit / watch-out
Less overstock from blind calendarsUnstable lead time raises stockouts
Clear signal of what / how much / whereIncomplete cards create expensive expedites
Limits work and inventory in processWithout a shift owner, the board stalls
Scales to e-Kanban and WMSDigitizing garbage produces faster garbage
Kanban cuts idle inventory only if lead time is honest.

When to use it in the warehouse and the WMS role

Use it on predictable-rotation SKUs (A/B), aisle-to-pick replenishment, packing materials, and supplier–DC flows with stable appointments. Avoid it as the only rule for highly erratic demand, new launches without history, or routes with extreme variability and no buffer.

The WMS confirms on-hand, locations, and moves. Kanban sets the cadence. If the WMS says “in stock” but the floor is empty, fix inventory accuracy before redesigning cards. See warehouse functions.

Signal to goSignal to wait
Measurable consumption by SKUNew SKUs with unknown demand
Replenishment + freight lead time calibratedWeekly expedites from missed appointments
Signal owner per shiftSignal only in Excel / WhatsApp
Trusted WMS or countsPhantom inventory without root cause
Truth of stock and lead time first; cards or e-Kanban second.

One warehouse vs a warehouse network (and the corridor)

In a single DC, kanban is usually internal replenishment: picking fires T toward reserve or the dock. In a network (plant, DC, satellite, customer), signals chain nodes: each link only reacts to the next link’s consumption.

On the Mexico–U.S. corridor the most dishonest link is often freight: crossing, dock appointment, and dwell. If the card assumes 24 hours and the trip takes 72, kanban “works” on the board and stockouts on the floor.

There the transportation management system (TMS) and trip evidence matter as much as the WMS: the warehouse signal cannot ignore real corridor lead time.

Kanban and stock management

Kanban does not eliminate safety stock: it sizes it. The buffer covers demand and lead-time variability; kanban sets replenishment cadence (lot size and number of cards or containers).

Practical rule: number of signals ≈ demand over lead time + safety stock, divided by container size. If you ignore freight variability, you “optimize” cards and buy stockouts.

Tie stockout alerts to cause (late signal, dishonest lead time, pick without scan), not only to raising every SKU’s buffer.

ElementQuestionNote
SignalContainer, card, or WMS event?One truth per SKU
Lot sizeHow much does each signal authorize?Calibrate by ABC
Lead timeIncludes freight and appointment?Use real data, not a wish
Reorder pointWhen does it fire?With an explicit buffer
OwnerWho acts on the shift?A name, not “the area”
Minimum cycle design before buying software.

How to run it in 6 steps

Start narrow: one aisle, one ABC family, or one supplier. Expand only when the cycle closes without invented expedites.

  1. Pick SKUs

    Stable consumption

  2. Define signal

    T, P, or buy

  3. Calibrate lot

    Real lead time

  4. Connect floor

    WMS or card

  5. Replenish w/ appt

    No WhatsApp

  6. Audit stockouts

    Adjust buffer

Kanban without measured freight lead time is lean theater.

Expensive mistakes

1.Copying cards without measuring consumption

Lot size becomes a guess and you overbuy or underbuy.

2.Ignoring freight variability

Replenishment breaks at the border, the dock appointment, or the yard.

3.Kanban only in Excel or chat

The signal reaches the floor late; board and reality diverge.

4.Zero safety stock by dogma

Extreme just-in-time on Mexico–U.S. routes is a recurring stockout.

5.Digitizing without clean master data

e-Kanban multiplies SKU, location, or supplier errors.

OCL and the trip file

In the warehouse, kanban is the pull signal. On the corridor, that same replenishment depends on a trip with appointment, evidence, and close in Finance. OCL is an autonomous transportation management system (TMS) with AI agents: it helps surface transport lead time and exceptions that feed replenishment, without managing cards or the WMS.

When the warehouse signal fires an inbound, the trip file (documents, proof of delivery, exceptions) is what makes lead time credible. OCL can stamp invoices and Carta Porte; humans stay on exceptions.

Sources and further reading

  1. Inventory · safety stock · stockout.
  2. Just-in-time · WMS · warehouse functions.
  3. TMS guide.
  4. Historical origin: Toyota Production System / Taiichi Ohno (kanban as a visual replenishment signal). Calibrate lot sizes with your operation; do not copy a catalog number.
Key takeaways6 points
  1. Logistics kanban = replenish only when there is consumption: a signal authorizes moving or making material.
  2. The card (or empty container) is not decoration: it carries product, quantity, lead time, supplier, and location.
  3. Transport kanban (T) moves material between points; production kanban (P) authorizes make or transform.
  4. Without honest freight lead time, kanban produces stockouts or overstock.
  5. e-Kanban digitizes the same signal (barcode or QR); the warehouse management system (WMS) executes the move; it does not invent the method.
  6. OCL does not manage cards or the WMS: it stabilizes lead-time evidence in the trip file. OCL can stamp invoices and Carta Porte.

Does your kanban trigger urgent freight?

Book a demo: measure real corridor lead time before redesigning demand-driven replenishment.

Frequently asked questions
